How to Build a Gabion Retaining Wall

Below you will find a step by step guide on how to build a gabion retaining wall.

Feel free to utilize the following information as a reference. If you have any uncertainties regarding the installation of your retaining wall, we advise reaching out to a Civil Engineer for guidance.

gabion-retaining-wall

OVERVIEW

  • Experience Required: Hard
  • Tools Required: Shovel, Tamper, Protective gloves, Spray paint
  • Materials Required: GabionHelical, Stone, Gravel, Geotextile

Step 1) Identify location

marking-the-location

  • Mark the location where you plan to construct your wall by using spray paint, rocks or alterative materials.

Step 2) Dig

digging-the-base

  • Due to regulations, the construction of retaining walls should always start at 50cm below the ground level.
  • Gabion walls that are lower then 2m can however be placed directly on the ground or at a lesser depth.
  • For retaining walls of this height, digging down 20cm-50cm, or until reaching a solid substrate like clay rather than the topsoil should suffice.

Step 3) 6 Degree Slope

six-degree-slope

  • When retaining a significant amount of soil, ensure the hole features a 6-degree slope leaning backward.
  • In the case of smaller or decorative retaining walls, it’s acceptable to maintain an upright edge instead of the 6-degree slope.

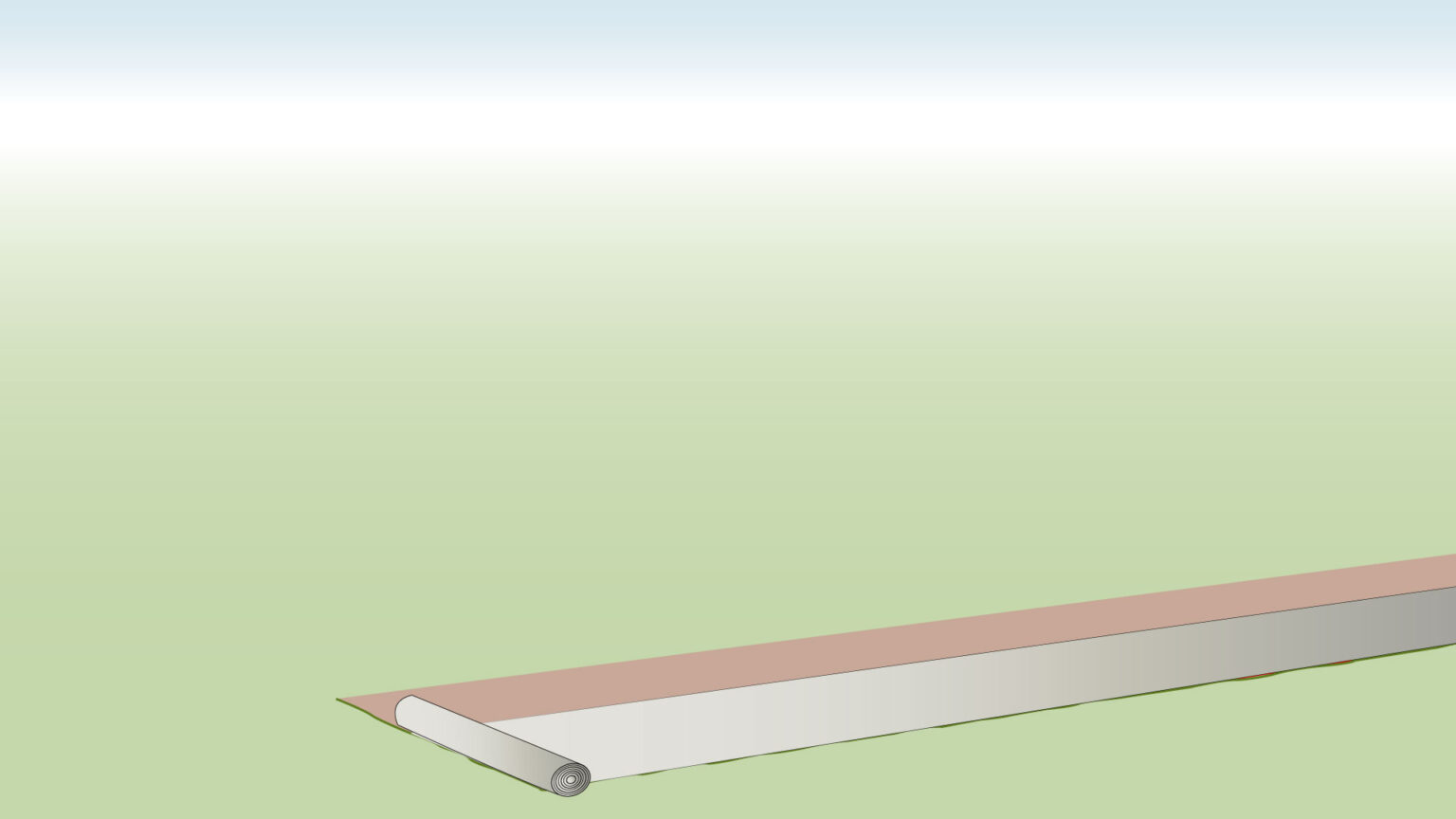

Step 4) Add Gravel

adding-gravel

  • Add a layer of gravel or basecourse measuring 20cm on top of the soil.

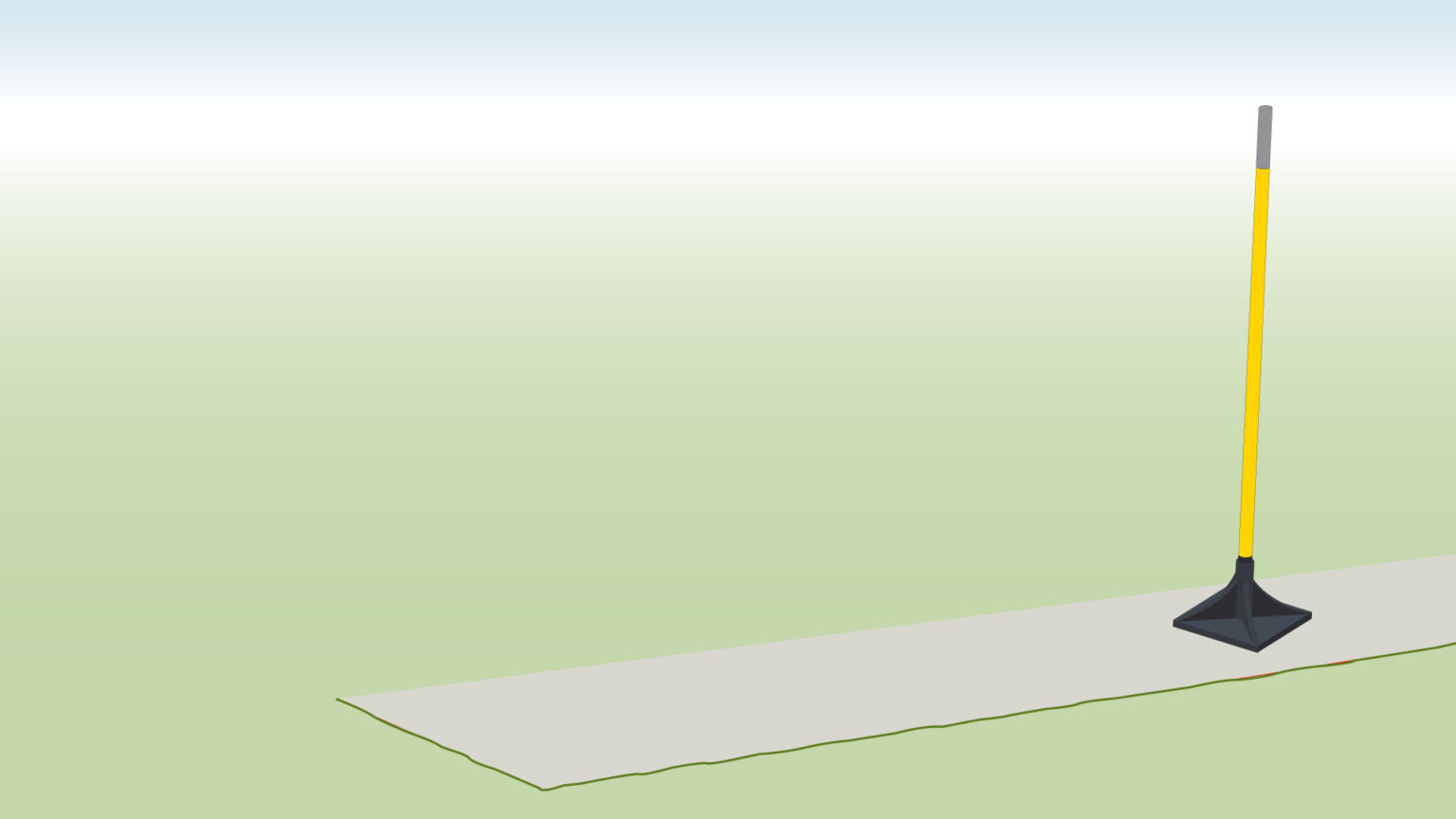

Step 5) Compact Gravel

compressing-gravel

  • Compact the gravel by walking and stomping on it.

Optional) Concrete foundation

  • Typically, low-level gabion walls don’t necessitate a foundation.
  • However, in cases of significant groundwater or weak soil conditions, a foundation might become necessary.

Step 6) Geotextile

geotextile

  • Apply a geotextile or weed mat to the rear of the gabion baskets to prevent soil and debris accumulation behind the wall.

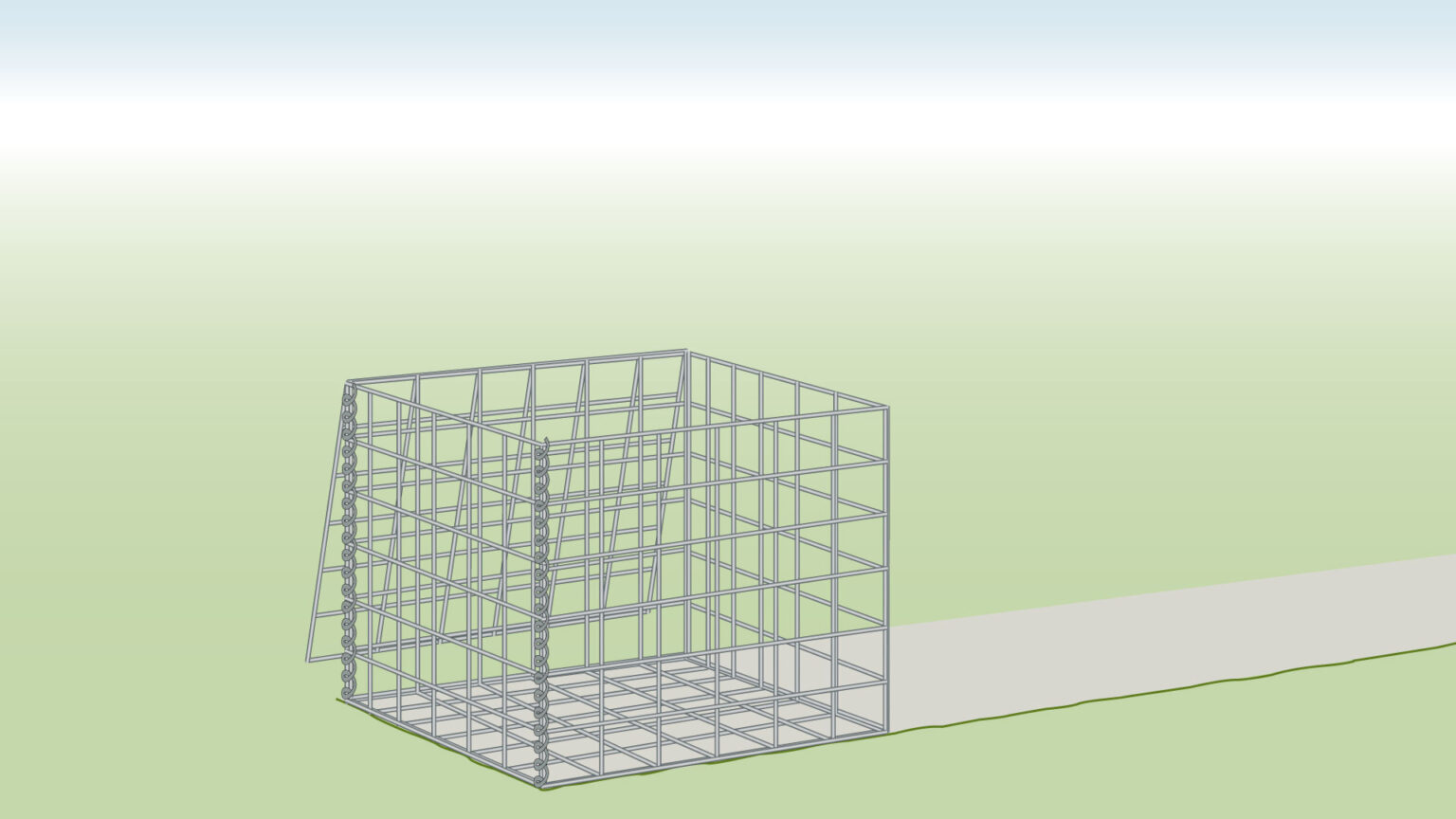

Step 7) Unfold the Baskets

fold-baskets

  • Unfold the gabion baskets, lifting the sides.

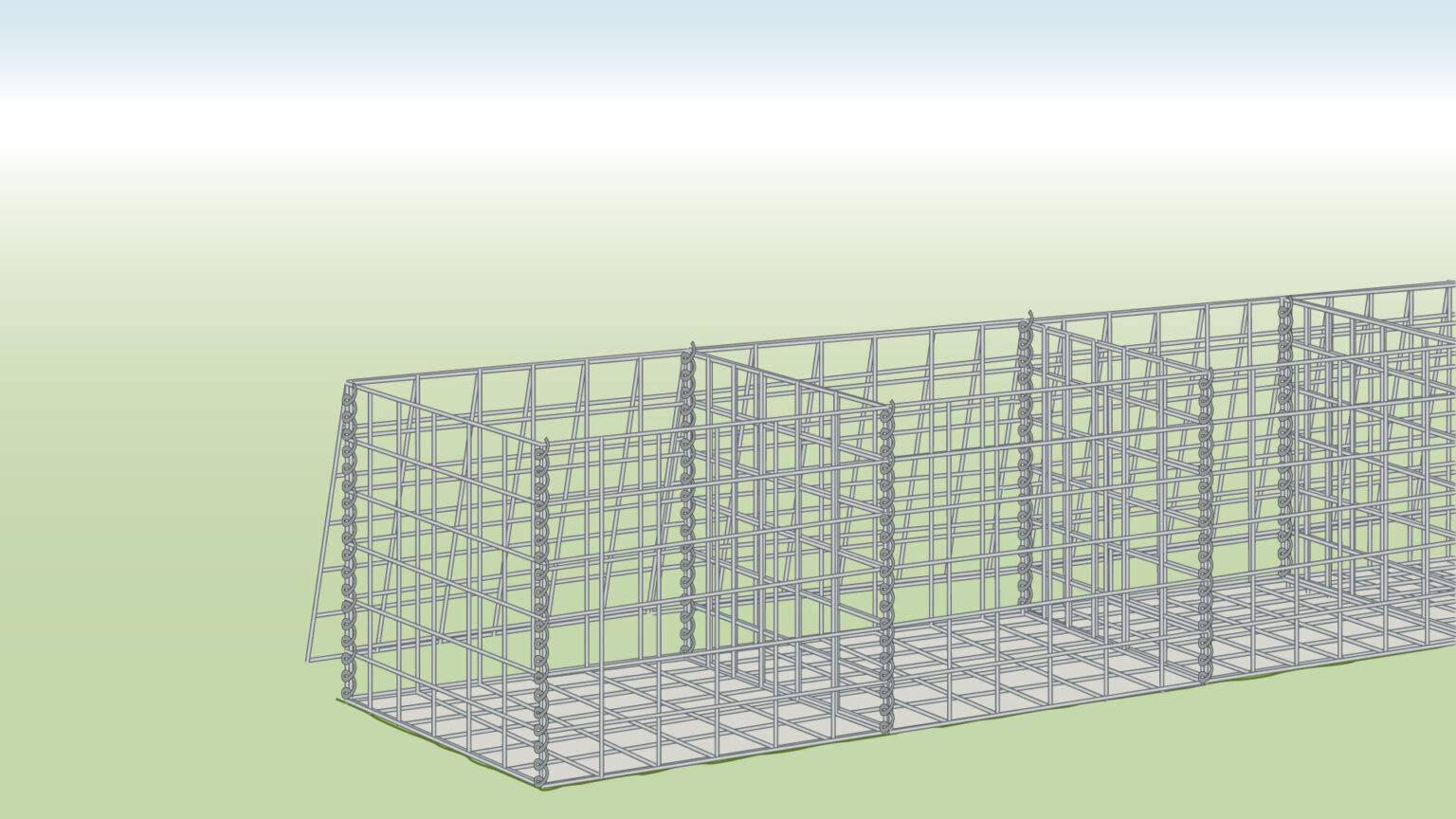

Step 8) Join the Cages

adding-helicals

  • Assemble the gabion baskets, following the instructions.
  • Use the helicals included in the kit.

Step 9) Fill with Stone

filling-gabions-with-stone

  • Use the stone of your choice to fill the gabions.

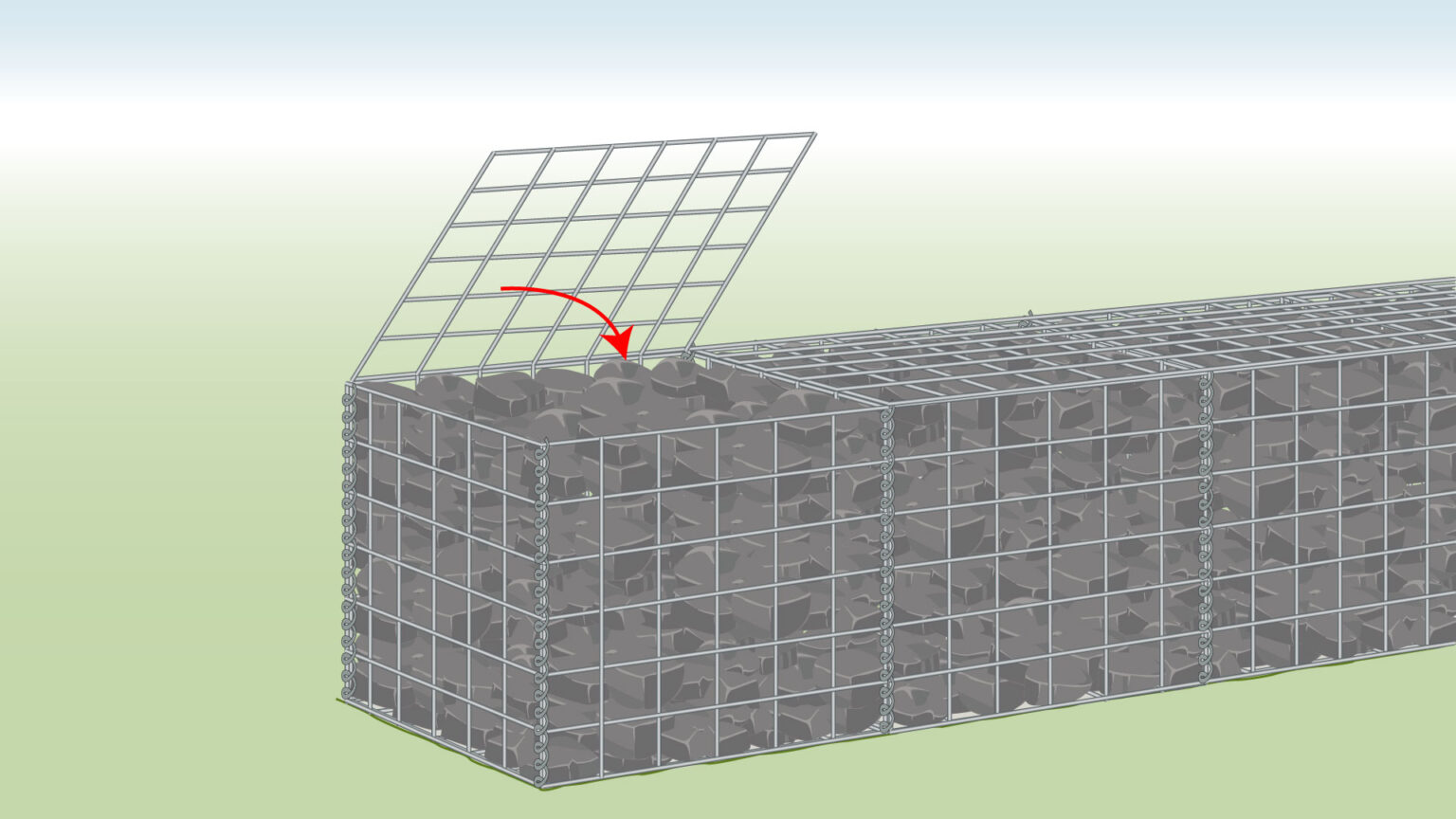

Step 10) Close Lids

closing-gabion-baskets

  • Close your baskets, folding down the lids.

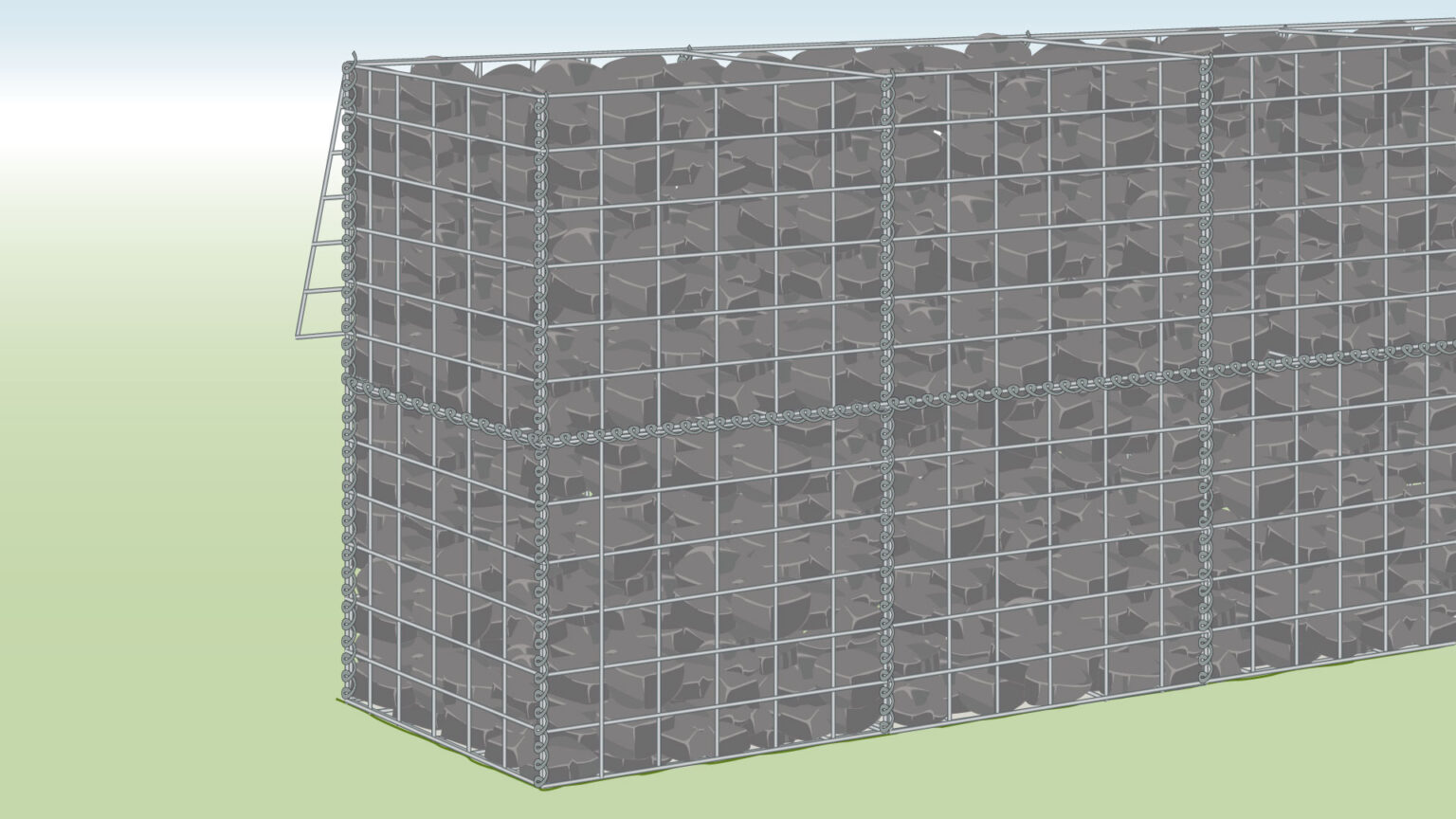

Step 11) Add Second Row

add-second-row-of-gabions

  • Position the second row of baskets directly above the first row, connecting them together using helicals.

Step 12) Fill and Join

fill-second-row

  • Fill the top baskets with rocks.
  • Enhance security by connecting the baskets with helicals from front to back. Adjustments may be required by cutting some of them to fit the wall’s depth.

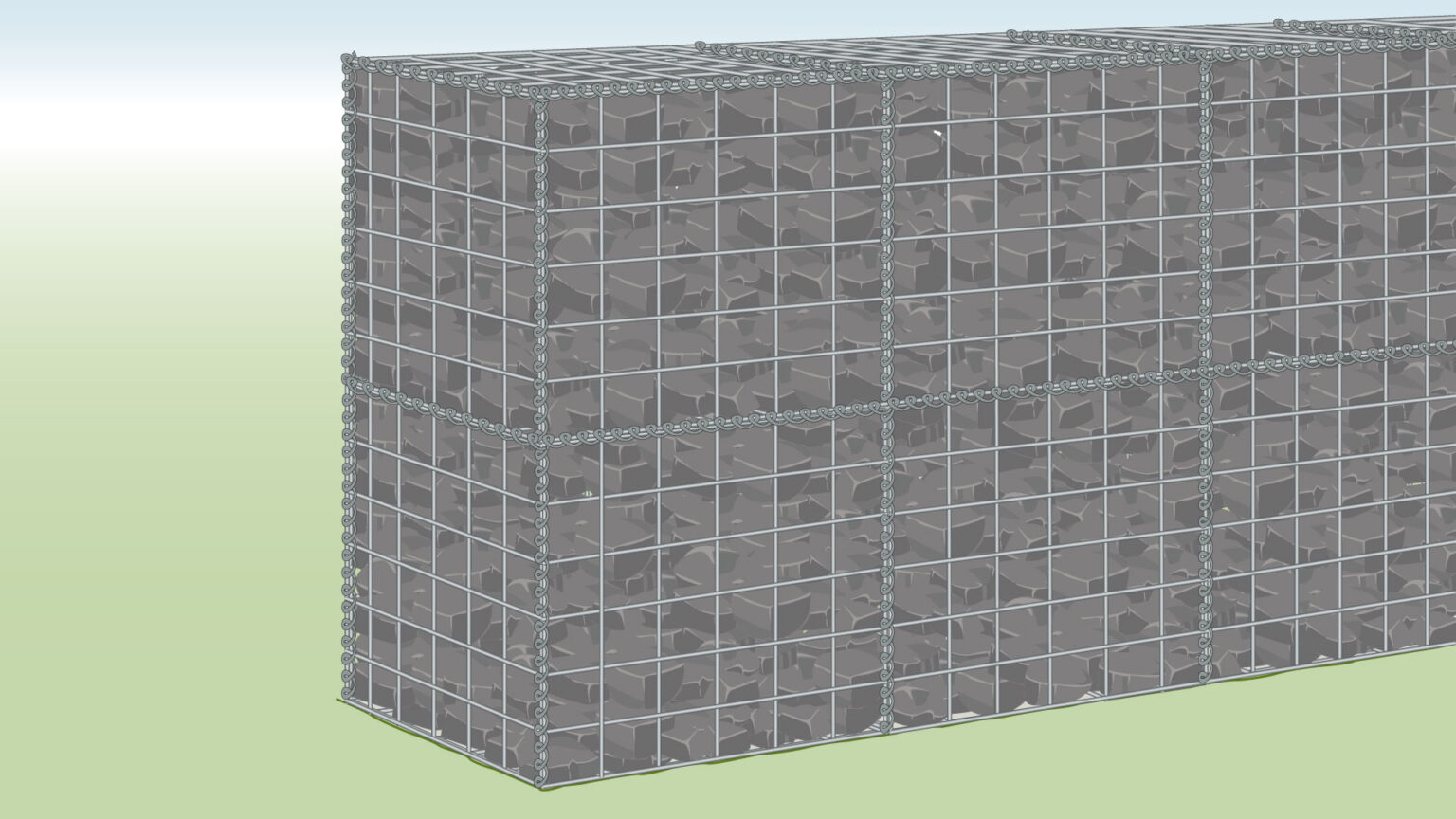

Step 13) Finished Project

how-to-build-a-gabion-retaining-wall

  • Your 2m gabion retaining wall is finished!
